How to Improve Utilization with Better Resource Scheduling

Sarah W. Frazier

Key Takeaways

  • Scheduling to get higher utilization starts with knowing available capacity, not simply finding empty calendar space.
  • Match work to skills, capacity, deadlines, and project needs rather than filling every available hour.
  • Compare available, scheduled, and actual time to identify workload, estimation, and capacity problems early.
  • Use historical delivery data to improve future estimates and make capacity forecasts more reliable.
  • Sustainable utilization preserves enough flexibility to absorb client changes and normal delivery variability.

Scheduling to achieve higher utilization means using capacity, skills, estimates, deadlines, and actual time data to redirect more available billable hours to the right client work. The goal is not maximum calendar fill but a schedule that allocates capacity to profitable client work while leaving enough flexibility to absorb normal delivery changes.

A healthy utilization rate can still hide a weak schedule. One consultant may be overloaded, another may have usable capacity, and a third may appear available because internal work has never made it onto the plan.

Before changing assignments, start by establishing where usable capacity actually exists.

What Scheduling to Get Higher Utilization Means

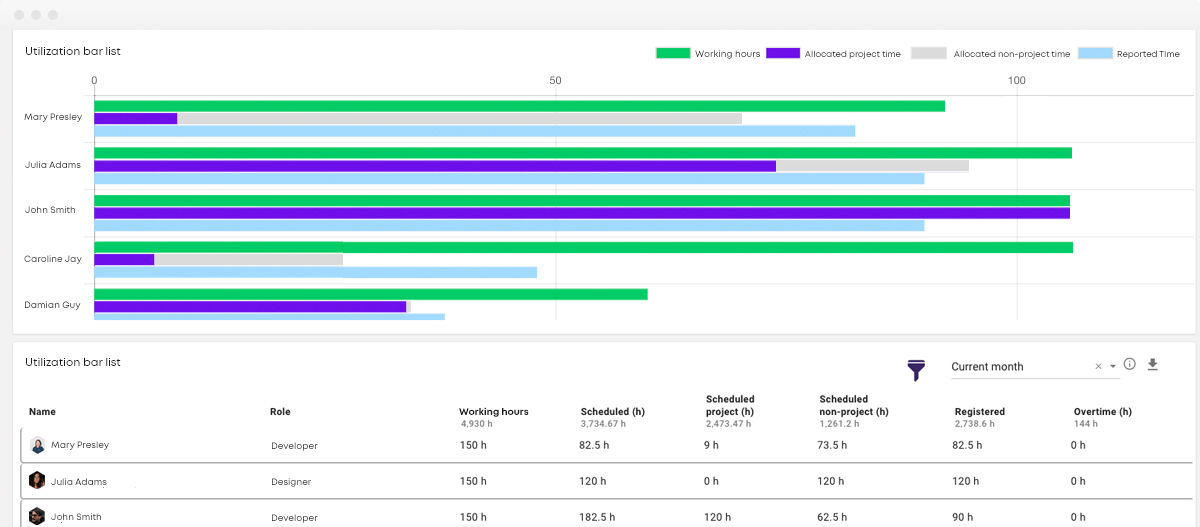

Schedule utilization shows how much available capacity has work planned against it. Resource and billable utilization add another question: how much of that capacity is being used productively and for revenue-generating client work?

The more useful measure is whether the right work is assigned to the right people at the right time without creating delivery or margin risk elsewhere.

Schedule utilization vs. resource utilization

The two concepts are related but useful for different decisions.

Utilization Metrics Comparison
MetricWhat It Helps You SeeWhat It Can Miss
Schedule utilizationHow much available capacity has planned work against itWhether the work is billable, profitable, or assigned to the right skill
Resource utilizationHow effectively available working time is being usedWhether the productive work generates revenue
Billable utilizationHow much available time goes toward revenue-generating client workWhether the work itself is well scoped or profitable

If you need the calculation itself, Accelo's guide to calculating resource utilization and billable utilization explains the formulas, while the utilization rate glossary provides a shorter definition and example.

Once the definitions are clear, the bigger scheduling mistake becomes easier to spot: treating maximum calendar fill as the goal.

Why is 100% scheduled time not healthy utilization?

A fully booked week leaves little room for the work that rarely appears neatly in the original project plan: client questions, scope changes, reviews, mentoring, business development, internal meetings, rework, and unexpected delivery issues.

Some of that time is necessary. Making it invisible does not make it disappear.

A person can therefore appear underutilized because necessary nonbillable work was excluded from the capacity plan. Someone else can appear perfectly utilized while carrying a schedule that becomes unsustainable the moment a client changes priority.

Accelo's analysis of the costs of pushing resource utilization too high goes deeper into why firms need enough capacity to respond to changing client and delivery demands.

The scheduling goal is better use of capacity, not elimination of every unused hour. That means the next step is getting the inputs right.

Build the Inputs Before You Change the Schedule

A scheduling decision is only as useful as the information behind it. Moving assignments around without accurate capacity estimates, skills, deadlines, and existing commitments can raise utilization in one part of the schedule while creating problems elsewhere.

Start by establishing what capacity actually exists and which work that capacity can support.

Map available capacity.

Available capacity is the amount of planned work someone can realistically accept after accounting for existing assignments and unavailable time. Do not stop at "Alex has 12 open hours." Ask what those 12 hours represent.

A practical capacity view should include:

  • Existing project and task commitments
  • Role and relevant skills
  • PTO and other unavailable time
  • Known internal responsibilities
  • Client support or recurring obligations
  • Deadlines
  • Estimated task effort

The same view should work at the individual, role, team, and time-period level. A firm can have overall availability but still lack the particular role an upcoming project needs. Resourcing and capacity planning helps surface those role- and skill-level constraints that total headcount can hide. That becomes even more important when likely pipeline work is included, because future demand may create a shortage that today’s schedule does not yet show.

Separate billable, nonbillable, and unavailable time.

Utilization becomes misleading when billable delivery, internal responsibilities, and unavailable time are treated as equivalent capacity.

Consider two consultants who both appear 90% scheduled. One may have most of that time allocated to profitable client delivery. The other may be carrying a heavy mix of internal meetings, presales support, and administrative work. Their schedules are equally full, but their billable utilization is not.

Match skills and role before filling capacity.

Available time cannot solve a skills shortage. Eight available hours from a senior engineer do not solve an eight-hour specialist data requirement unless the skill and cost fit the work.

Good resource allocation considers:

  • Skill fit
  • Role and seniority
  • Current workload
  • Relevant past performance
  • Client or project context
  • Task priority
  • Deadline
  • Available capacity

Once those inputs are trustworthy, scheduling becomes an allocation exercise rather than a guessing game.

Allocate, Balance, and Rebalance Work

Higher utilization is usually achieved through ongoing adjustments: assigning new work quickly, resolving unassigned demand, and rebalancing workloads before capacity sits idle or overload begins to affect delivery.

Move from project allocations to task-level scheduling.

"Jamie is 80% allocated to Client A this month" gives you a useful portfolio view. It does not tell you what Jamie needs to complete on Tuesday.

Task-level scheduling adds the information required for daily utilization decisions.

Task Assignment View
TaskEstimateSkill NeededAssigned ToAvailable CapacityDeadline
Discovery analysis6 hrsStrategyConsultant A8 hrsTuesday
API configuration10 hrsIntegrationEngineer B6 hrsThursday
Client review3 hrsAccount leadUnassigned5 hrsFriday

The project may appear fully staffed while the table shows that Engineer B is short on capacity and the client review has no owner. Now the resource manager has something actionable to solve.

Balance workloads before either extreme becomes expensive.

The same schedule can contain unused capacity in one part of the team and unsustainable workloads in another.

Unused capacity represents billable time the firm cannot recover later. Sustained overload increases the likelihood that work slips, estimates deteriorate, or the team compensates with longer hours. A weekly scheduling review can surface both.

Ask:

  • Who has meaningful unused capacity?
  • Who is carrying more work than the schedule can realistically support?
  • Which high-priority tasks remain unassigned?
  • Which estimates have changed?
  • Which deadlines are now at risk?
  • Can work move without sacrificing skill fit or client context?

Do not move an assignment simply because someone else has an open calendar. Rebalance only when the alternative resource also fits the skill, priority, and client requirements of the work.

Triage new and unassigned work explicitly.

New work arrives after the schedule is built. Scope changes. Client requests appear. Tasks get added during delivery. Unassigned work understates future demand: the effort is real even when no one has been scheduled to deliver it.

Before placing new work, check five things:

  1. Priority: Does this work displace anything already scheduled?
  2. Deadline: When does it genuinely need to be completed?
  3. Estimate: How much capacity will it require?
  4. Skill fit: Who can perform the work effectively?
  5. Capacity: Who can take it without putting another commitment at risk?

That keeps the schedule aligned with current delivery demand rather than the assumptions made at kickoff.

The next question is whether those scheduling changes are actually improving utilization.

Review Utilization While You Can Still Change the Outcome

A utilization report is most useful while there is still time to change the schedule. Compare available capacity with planned work, then compare the plan with what delivery actually consumed. That three-way view shows whether the problem is allocation, estimation, execution, or demand.

Compare available, scheduled, and actual time.

Review these three numbers together:

  • Available time: Capacity the person could realistically use.
  • Scheduled time: Work the team planned against that capacity.
  • Actual time: Time the work ultimately consumed.

Suppose a consultant has 32 available hours, 30 hours scheduled, and records 38 hours of actual effort. The scheduling problem is not low utilization. The variance suggests that estimates, scope, or workload assumptions need attention.

If the same type of work repeatedly takes 25% longer than estimated, continuing to build future schedules from the old estimate will create artificial capacity every week. That is why utilization reporting and estimation should inform each other.

Accelo's utilization dashboard guide delves into how to translate utilization data into staffing and profitability decisions.

Report the decision, not only the percentage.

A utilization percentage is only useful to leadership when it points to a decision.

A useful summary might show:

  • Current utilization trend
  • Teams or roles with excess capacity
  • Overloaded roles
  • Unassigned demand
  • Project or margin risk related to staffing
  • Hiring or contractor implications
  • Recommended action

That connects utilization to the decisions leadership actually needs to make.

Bringing those signals together through business intelligence makes the report more useful by showing not only where utilization stands, but also where capacity, staffing, or margin require action.

Improve the Next Schedule With Better Estimates

Once you compare planned work with actual delivery, the scheduling process should become more accurate over time. Historical time data is useful because it turns memory-based estimation into evidence.

Use recorded time to tighten estimates.

Recorded actual time against tasks and projects gives you a better basis for future estimates.

Build an estimate review loop:

Estimate → schedule → deliver → record actual time → compare → update the next estimate

If design reviews consistently require eight hours rather than the five hours in your standard template, future scheduling should account for eight hours.

Better estimates also make capacity and utilization forecasts more credible because scheduled demand more closely reflects the effort delivery will actually require.

Use AI as decision support, not autopilot.

AI can compare skills, availability, workload, historical performance, and upcoming demand to surface stronger staffing options and potential capacity constraints. AI can also help model how likely pipeline work could affect future capacity before that demand becomes committed.

Project managers still bring context AI may not fully capture, including client relationships, development goals, recent scope changes, and competing priorities across engagements.

AI works best when it shortens the path to a better decision. It does not remove the decision.

Scheduling Mistakes That Keep Utilization From Improving

By this point, most utilization problems become easier to diagnose because they usually trace back to one of a few scheduling habits.

Filling capacity without considering margin.

More billable work does not necessarily mean better economics. Underpriced, out-of-scope, or poorly estimated work can increase utilization while reducing margin, particularly on fixed-fee and recurring engagements. Monitor utilization alongside project financials, especially for fixed-fee and recurring work.

Waiting until month-end to rebalance.

Historical reporting shows what happened. It cannot recover last month's idle capacity or undo a week when the same specialist was booked across three projects. Reviewing the schedule while delivery is underway gives you more options.

Planning based on standard working hours instead of usable capacity.

A 40-hour workweek is not the same as 40 hours available for client delivery. PTO, internal responsibilities, presales support, recurring client obligations, and other committed time reduce the capacity that can realistically be scheduled.

Managing only at project level.

A project can look correctly staffed while its critical tasks remain overloaded or unassigned. Keep the high-level allocation for portfolio planning, but move into task-level detail when you need to make near-term scheduling decisions.

Planning only from confirmed work.

A schedule can look balanced against today's committed projects and still be headed toward a capacity problem. Likely pipeline work, tentative bookings, and known upcoming resource requirements give you an earlier view of where demand may exceed available skills or capacity.

Make Utilization More Sustainable, Not Simply Higher

Higher utilization is most sustainable when it comes from better decisions rather than tighter calendars. The more accurately you can see available capacity, upcoming demand, skill requirements, actual delivery effort, and financial impact, the earlier you can correct underuse or overload before either affects revenue, margin, or the team.

Accelo connects resource and capacity planning, project delivery, utilization, and project financials, so decisions can be made from a single operating view. Book a demo to see how Accelo can help you improve utilization without making maximum calendar fill the goal.

Frequently Asked Questions

What does schedule utilization mean?

Schedule utilization shows how effectively available working capacity is matched to planned work. In professional services, read it alongside billable utilization, skills, nonbillable commitments, and workload so a full schedule is not mistaken for healthy utilization.

How can scheduling increase utilization rate?

Scheduling improves utilization by exposing capacity gaps, overload, unassigned work, and skill mismatches early. Managers can then reallocate suitable work before idle time or overbooking begins affecting revenue or delivery.

Should you schedule every available hour?

No. A fully booked calendar leaves little room for client changes, internal responsibilities, reviews, and unexpected delivery work. Healthy utilization preserves enough capacity for the team to absorb normal variation.

What data do you need before changing schedules?

Use realistic available hours, current assignments, skill and role information, task estimates, deadlines, nonbillable commitments, unavailable time, and recorded actual time. Without those inputs, resource scheduling is largely guesswork.

How often should utilization be reviewed?

A weekly review works well for many active project teams, with more frequent checks when deadlines, scope, or staffing change materially. The cadence should match how quickly your delivery plan changes.

Can AI improve resource scheduling?

AI can support resource scheduling by identifying patterns, surfacing capacity risks, and recommending potential assignments from reliable operational data. Managers should still validate skill fit, client context, priorities, and team constraints.

Which metrics show whether utilization is improving?

Review billable utilization, scheduled versus available capacity, actual versus estimated time, workload distribution, and relevant margin indicators together. A single utilization percentage can hide poor estimates, overbooking, or low-value work.

This article was originally published on July 22, 2022, and was updated on September 5, 2026, for accuracy and relevancy.

CTA Shortcodes with the layout set to "Content" and theme set to "Light"
No items found.
CTA Shortcodes with the layout set to "Content" and theme set to "Dark"
No items found.
CTA Shortcodes with the layout set to "Trial"
No items found.
CTA Shortcodes with the layout set to "Tour"
No items found.
CTA Shortcodes with the layout set to "Demo"
No items found.
CTA Shortcodes with the layout set to "Embed"

Sarah W. Frazier

Sarah is a seasoned writer and content creator, with over two decades of experience helping B2B tech and service organizations grow. She specializes in translating complex operational challenges into insightful and actionable content to educate agencies, consultancies, and IT service organizations and drive measurable business impact.

Table of Contents

See what profitable growth looks like.

Book a Demo

Explore more posts

Ready to end the chaos and start operating profitably?

Profitable delivery isn’t by chance — it happens when your team has the right info at the right time. Accelo's connected, AI-driven platform puts profitability on repeat, at any scale.

Book a Demo
